Cost Managment

  • Writer: Anand Nerurkar
    Anand Nerurkar
  • Nov 15, 2023
  • 2 min read

Updated: Nov 16, 2023


Direct Cost -For a project

Resource/Material Cost

Training Cost

Travel Cost

specific infrastructure need to purchase

software licensing cost


Indirect Cost

This is cost for supporting your business, not specific to your project.

Fringe Benfits

General Admin expenses

HR Expenses


Variable Cost

Performance Bonus

Freight Expenses

Sales commision


Fixed Cost

General expenses

rent

depreciation

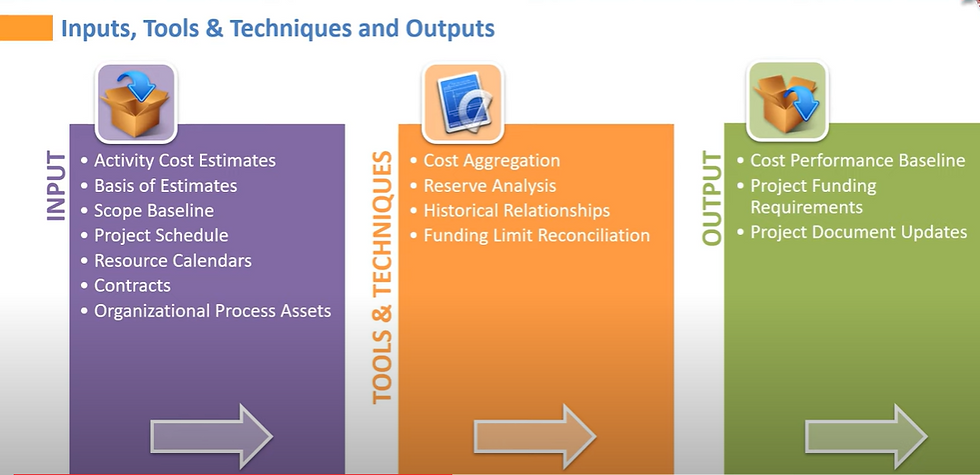

Estimate Cost Process

===



Determine Budget Process

====

Reserve Analysis

==

Contingency Reserve--- known unknown risk--- generally 10-15 % of proejct cost estimate

Risk Response Budget--- Based on Risk Register- we have planned certain risk response as mitigation strategy , so we need to set aside cost

Management Reserve - generally 10-15 % of proejct cost estimate, this is not accessible for for the PM. This is reserved for unknown unknown risk.


Project Budget= project cost + Contingency Reserve + Risk cost + Management Reserve

Cost Baseline=project cost+continegency reserve




Control Cost Process

===





Earn Value Management

==





Cost Forecasting (Performance Based)

===





Here in this , we are not taking into account performance, we are not considering how much work is left


so we need to consider EV and then calculate ETC as below



above is valid at the start of project, but as project progresses, we need to track changes,need to measure performance.If project performance is a bad, then we need more money to finish the project.so we need to consider performance factor to get ETC formula as below.


performace fctor < 1 , ETC will be more


performace fctor = 1 , no impact on ETC


performace fctor > 1 , ETC will be less, i am doing very well




other formula is

Performance factor may be CPI - cost performance index or SPI- schedule perfrmance index


if Performance factor is CPI - cost performance index

This can not be used thoughout project life cycle


Tips

==






As PEr PMI

==
















SV=40-40=-10

SV is negative, mena project is behind schedule


Cost Forcasting

===













Recent Posts

See All
Best Chunking Practices

1. Chunk by Semantic Boundaries (NOT fixed size only) Split by sections, headings, paragraphs , or logical units. Avoid cutting a sentence or concept in half. Works best with docs, tech specs, policie




Future State Architecture

USE CASE: LARGE RETAIL BANK – DIGITAL CHANNEL MODERNIZATION 🔹 Business Context A large retail bank wants to “modernize” its digital channels (internet banking + mobile apps). Constraints: Heavy regul





Comments

Rated 0 out of 5 stars.
No ratings yet

Add a rating
  • Facebook
  • Twitter
  • LinkedIn

©2024 by AeeroTech. Proudly created with Wix.com

bottom of page
